Baselines & Variance Analysis: The Truth in Project Tracking

In professional project governance, a schedule is not a static document—it is a binding commitment. However, in a real-world environment, the "plan" is an assumption that is constantly tested by reality.

Without a baseline, a project manager is merely tracking "current status," which is a dangerous practice. To truly govern a project, you must track Variance: the mathematical delta between the Promised Plan and the Actual Execution.

A Baseline is a professional snapshot of your project's schedule (start dates, finish dates, and work effort) captured at the moment of formal stakeholder approval.

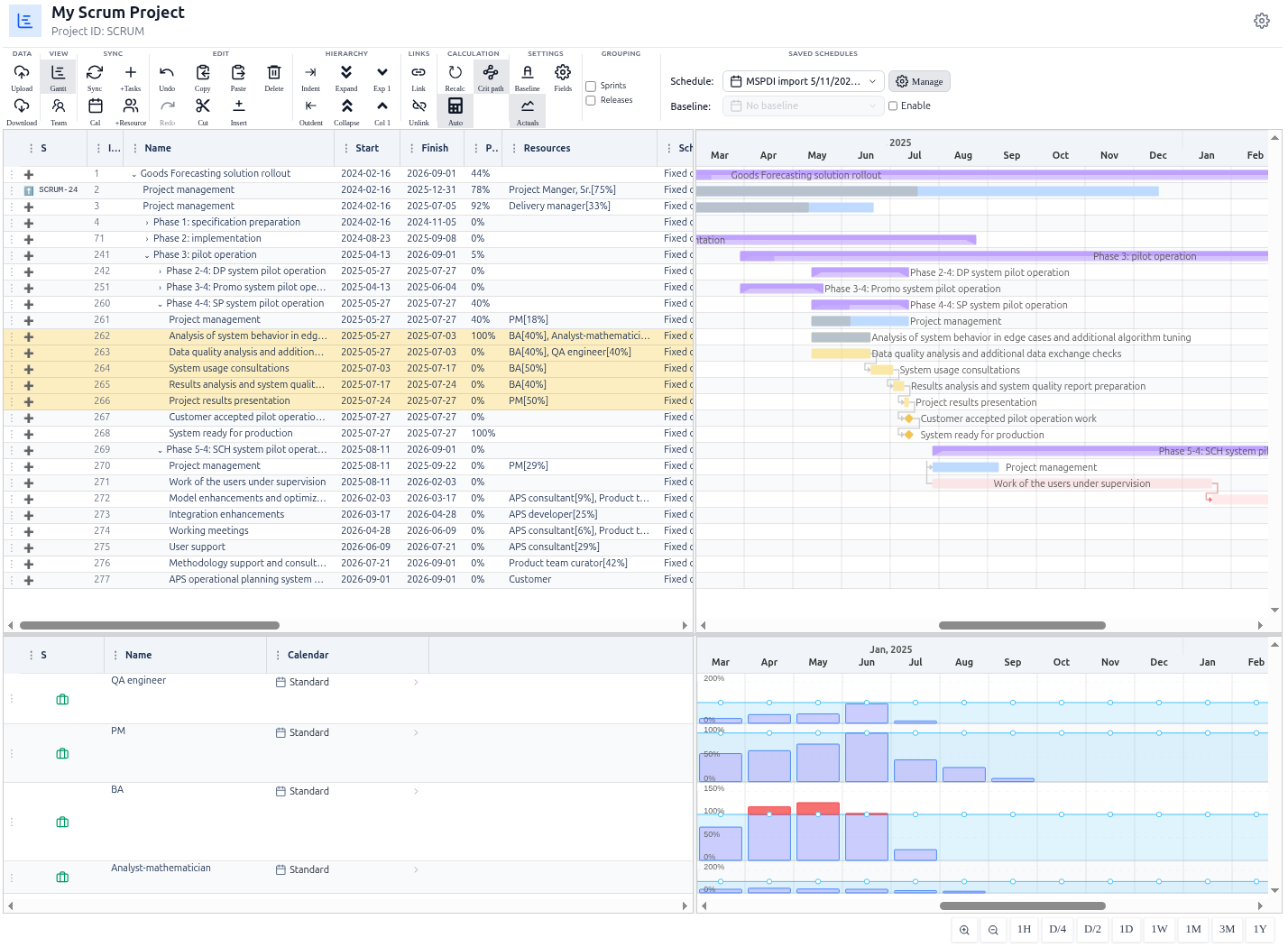

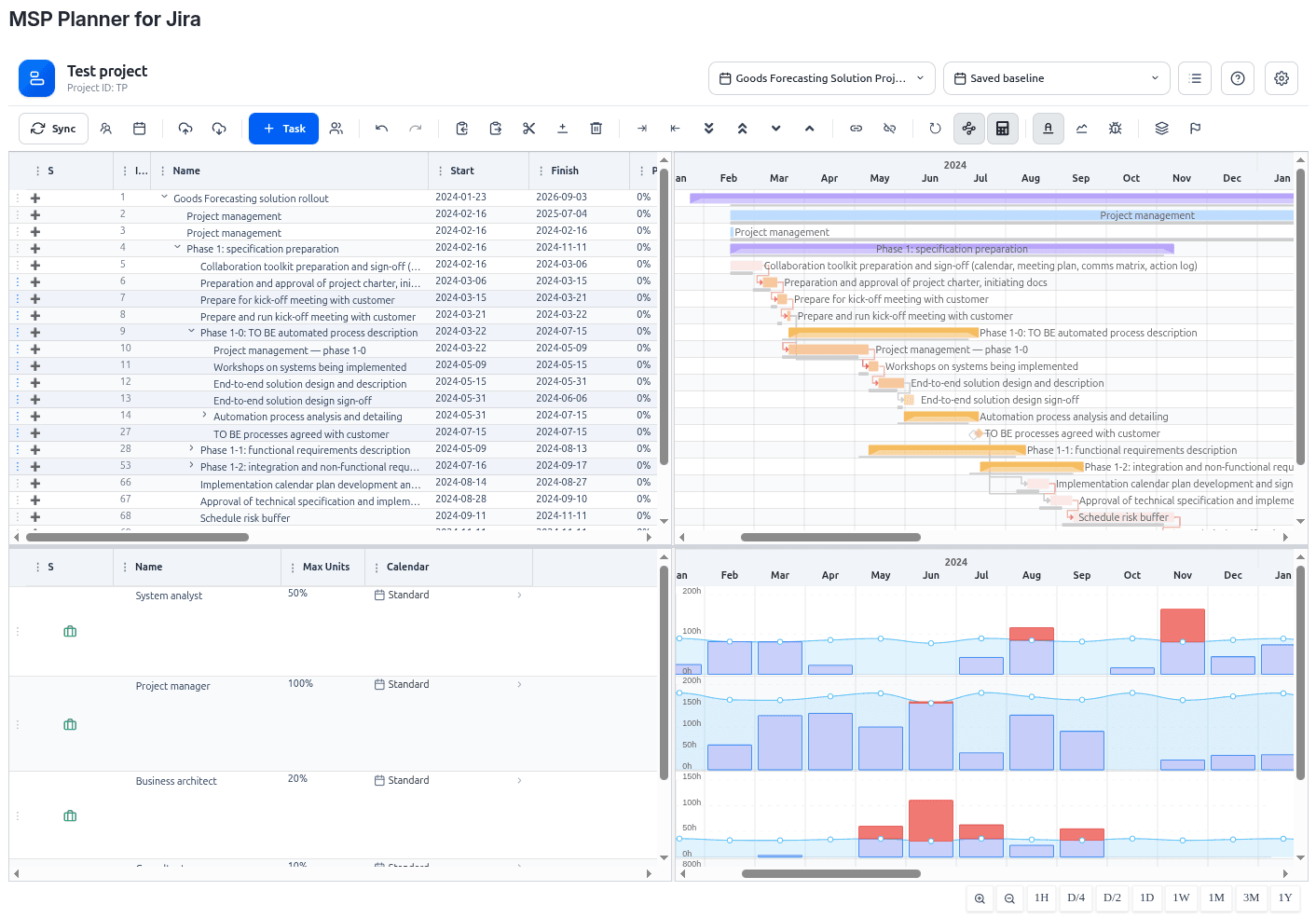

Baseline View

1. The Comparative Overlay System

MSP Planner implements a Comparative Overlay system, allowing you to visualize drift in real-time without altering your current plan.

How to Visualize Drift

To compare your current progress against a previous commitment:

  1. Select a Baseline Schedule: Use the Schedules Selector in the toolbar to load a previously saved baseline schedule as the comparative target.
  2. Toggle the Baseline View: Click the Baseline toggle in the toolbar.
  3. Interpret the "Ghost Bars": The app merges the baseline dates into your current view as thin, shaded bars beneath your live tasks.
    • The Live Bar: Represents the current scheduled reality of your working plan.
    • The Baseline Bar: Represents the approved commitment.

This visualization allows any stakeholder to instantly identify Negative Drift (slippage) or Positive Drift (acceleration).


2. Materializing the Baseline (Baking the Promise)

While the overlay is great for visualization, there are times when you want to "bake" the baseline dates directly into your current schedule's record.

The Materialization Workflow

When a formal "Change Request" is approved and you need to reset the project's "Truth" to a new agreed-upon state:

  1. Select the Target Baseline: Ensure the correct baseline schedule is loaded as the comparative overlay.
  2. Trigger Materialization: Use the Materialize action from the baseline menu.
  3. Confirm Overwrite: Because materialization is a destructive operation, you will be asked to confirm. This copies the dates from the overlay into the persisted baseline fields of your working tasks, clearing any previous snapshots.

3. The "Triple-Point" Governance Framework

Professional PMOs do not just compare the plan to the baseline; they use a three-point analysis to isolate the cause of project slippage.

The Three-Point Analysis

By using the Baseline Overlay and the Actuals Toggle simultaneously, you can analyze:

  1. Planning Variance (Baseline vs. Planned): Did we underestimate the work? If the planned bar has drifted from the baseline, the original estimate was likely optimistic.
  2. Execution Variance (Planned vs. Actuals): Are we performing as expected? If the actual worklogs (Actuals) are trailing the planned bar, the team is under-performing.
  3. Total Drift (Baseline vs. Actuals): What is the final impact on the delivery date?

This framework allows you to distinguish between a planning failure and an execution failure, which is critical for accurate reporting to Steering Committees.


Practitioner's Perspective: Advanced Variance Governance

Experienced PMO leads use baselines not just for tracking, but for strategic communication.

🚩 The "Honest" Steering Committee Report

The most common mistake in project reporting is presenting the current schedule as the only truth. A professional governance report focuses on the Variance:

  • Weak Report: "The API integration is scheduled for October 15th."
  • Professional Report: "The API integration has slipped by 4 days against the approved baseline. However, we have neutralized this by accelerating the 'Frontend Layout' task, resulting in zero impact on the overall project finish date."

⚖️ Materializing and Resetting Commitments

In long-term enterprise projects, scope creep is inevitable. MSP Planner allows you to materialize a new baseline:

  • When a formal "Change Request" is approved, you can update the baseline to reflect the new agreed-upon dates.
  • This prevents the "eternal slip" feeling, where the project is always late compared to a plan that is no longer valid.

📉 Predictive Trend Analysis

By analyzing the rate of drift across multiple tasks, a PM can identify systemic issues. If 80% of tasks are showing negative drift, the problem is likely not the tasks themselves, but an over-optimistic resource plan or an underestimated complexity.


Governance Checklist for Baselines

StepActionOutcome
ApprovalSet baseline immediately after sign-offLegal/Formal commitment established
Weekly ReviewCompare Live vs. Baseline barsEarly detection of "hidden" slippage
Change ControlMaterialize new baseline after approved CRMaintains reporting integrity
End of PhaseArchive phase baselineHistorical performance data for future estimation
